- EBMS Knowledge Base
- Job Costing
- Progress Billings
-
Client Resources
-
EBMS Main Documentation
-
Sales
- Customers
- Proposals
- Proposal Sets and Templates
- Sales Orders
- Sales Invoices
- Materials Lists
- Sales and Use Tax
- TaxJar
- Recurring Billing
- Customer Credits
- Customer Payments
- Card Processing and Koble Payments
- Gift Cards and Loyalty Cards
- Verifone Gateway and Point Devices
- Freight and Shipping
- General Ledger Transactions for Sales
- Point of Sale and XPress POS
- Point of Sale Hardware
- Salesperson Commissions
-
Inventory
- Product Catalog
- Using Product Codes for No Count Items
- Product Pricing
- Special Pricing
- Tracking Inventory Counts
- Unit of Measure (UOM)
- Purchasing Stock
- Special Orders and Drop Shipped Items
- Receiving Product
- Barcodes and Inventory Scanners
- Components, Accessories, and Bill of Materials
- Component Formula Tool
- Made to Order Kitting (MTO)
- Configure to Order Kitting (CTO)
- Multiple Locations: Warehouses, Divisions, Departments
- Sync Product Catalogs between Companies
- Vendor Catalogs
- Serialized Items
- Lots
- Product Attributes
-
Expenses
-
Labor
-
Financials
-
Tasks and Work Orders
-
Job Costing
-
Manufacturing
-
Rental
-
Apps
-
E-commerce
-
EBMS Automotive
-
EBMS Horticulture
-
EBMS Metal Supply
-
EBMS Fuel Sales
Creating Change Orders within a Progress Billing Tab
A change order is a change to the original contract or budget. A job normally has a single job contract or budget but has many change orders. Change orders for a progress-billing job, with exception of Time and Material change orders, will create a new billing line or increment an existing billing line within the Progress Billing tab. (Review the Contract Billings > Billing Time & Material Change Orders Within a Contract Billing section for details on Time & Material change orders within contract jobs). You cannot distribute the value of a change order to multiple progress-billing lines.
Go to the Budget tab within the main Jobs window and click on the New button to create a new change order and the following wizard will appear:

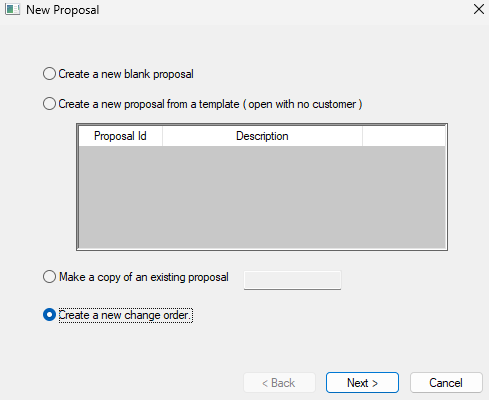

Select the fourth option Create a new change order; click the Next button to continue.
Select Yes to apply the change order costs to the progress-billing's scheduled value. The No option should be used only in Time & Material change orders that do not effect the progress-billing amounts. Review the Contract Billings > Billing Time & Material Change Orders Within a Contract Billing section for details. Click Next to continue.
Select the Create a new progress-billing line for this change order option to create a new line within the Progress-billing table. A change order should create a new line or be added to another existing progress-billing change order line rather than changing the original quote amounts. The system does not bar the user from posting to an item created from the main quote if this is required in rare occasions. Select the Add the change order to an existing progress-billing line option if you wish to add to an existing progress-billing line that was created by a previous change order. This option will be disabled if the current job does not contain any existing progress billing change orders.
Click the Next button to open the next page of the wizard.
The New Reference Number value will default to the next available proposal number.
Enter a short Description of the change order and the text will copy to the Progress-billing Description field. The Progress-billing Description text will be inserted into the new Progress-billing item.
The Progress-billing Item ID will default to the change order (New Reference Number) code and will be copied into the progress-billing form's ID column. This item Id can be changed to any other value that identifies this progress-billing item but is required to be unique within the current job.
Enter a Revenue G/L account to be used when billing a change order. This account will be used when the progress-billing invoice is created. See the G/L Account column within the Progress-billing tab of the job.
Click the Finish button to open the new change order. Enter the change order information in the same way as any other quote or proposal. Review the Jobs > Entering a New Proposal or Job Budget section or the Proposal documentation for more details on entering budgets and proposals.
